		Comparing Forecast vs. ActualFor any given ProjeX sheet, one 'status' can be
stored to be used for later comparison - what does this mean? Lets suppose we have spent a few days developing
a project plan and Gantt chart to submit with our proposal to a
client prior to being awarded the contract. This would be a
useful baseline for us to use to track the actual progress of the
project. Our client is going to expect us to keep to our initial
proposal so as we update the project tasks with their process we
can generate comparison Gantt charts. As on the previous page
let's use ProjeX's option to copy the 'Proposal' sheet to one
called 'Status'. All the updates to the progress of the project
will be made on this sheet. With the 'Status' sheet active we can take a
snapshot of the current task setting (start and end dates and
percentage completed).
 From the ProjeX menu we select the 'Take snapshot
of current ProjeX' option. This brings up a dialog asking for a name for the
snapshot, here we are recording the initial proposal so lets call
it 'Proposal'.
 On clicking OK nothing really seems to have
happened to the ProjeX sheet but actually a number of columns
have been added to the sheet and the current status (dates and
percentage completed) recorded. The present date (as set in the
Gantt chart in cell E6 at the time) is also saved with the
snapshot and is used to color the bars of our baseline when we
generate a comparison chart.
 The information (dates and status) stored by
ProjeX in these hidden columns should not be modified by the
user. As the project progresses and tasks are completed or
delayed the changes should be made to the usual part of the
ProjeX sheet (in this example columns J to M). We now have stored the 'snapshot' of our proposal, now
		lets copy the sheet (using ProjeX's functionality under 'ProjeX
		Properties') so that we have a sheet to update as the project
		progresses. Let's call this sheet 'Status'. After the first week we can modify the task
information to show what progress we have made and regenerate the
Gantt chart.
 We can then use the 'Compare snapshot' option to
generate a comparison plot between the status of the project now
(at the end of week 1) and the snapshot we took (our initial
proposal). ProjeX stores the information on a separate sheet -
for this example let's call it 'Week1 Status'.
 We can continue this as the weeks progress, changing the
durations of tasks as required so for example for week5 we might have (note -

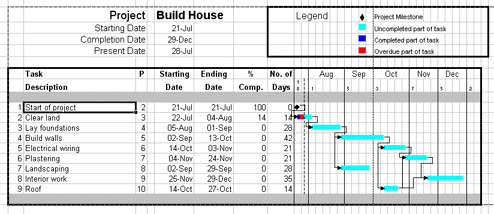

the dependency arrows have been turned off):
 As you can see from the above comparison, the
previous project status is using the date the snapshot was taken
(July 21st) as the present date so none of the tasks are colored
red, however the current status (in solid) is using the current
date set on the sheet so a number of the tasks are colored red to
show they are running behind. The comparison Gantt plot is always
generated in a new sheet.
